A middle-mile fiber route may look like a simple line on a construction map. But from a permitting and traffic control standpoint, it can be anything but simple
A telecom build along Colorado’s Front Range can move from one municipality into another, cross county right-of-way, intersect a CDOT highway, and pass through everything from residential streets to major arterials. Each transition can introduce a different permitting authority, different review expectations, and potentially a different approach to the Traffic Control Plan (TCP).
For OSP engineers, project managers, and telecom contractors, that creates a challenge: How do you keep traffic control planning from becoming a bottleneck on a multi-jurisdiction fiber build?
The answer starts with treating TCP development as part of the overall construction and permitting strategy—not as a document to produce at the end.
Why Multi-Jurisdiction Fiber Routes Get Complicated
Fiber construction rarely follows municipal boundaries neatly.

A route through the Denver metro area might begin on a local street, continue along a larger arterial, cross into another city, and eventually encounter CDOT-controlled right-of-way. The physical fiber installation may remain relatively consistent, but the authority reviewing the work can change several times.
That matters because there isn’t one universal submittal process for every Colorado jurisdiction.
The MUTCD provides the broader framework for temporary traffic control, but local agencies can have their own requirements for plan format, work hours, pedestrian routing, lane closures, notes, device placement, and other details.
A TCP that works for one portion of the route may therefore need to be modified—or developed differently altogether—for the next.
Start With the Route, Not the TCP
One of the best ways to reduce problems later is to identify jurisdictional boundaries early in the project. Thankfully, in Colorado the state publishes Google Earth KMZ’s that show city and county boundaries (see here for Colorado Geospatial Portal link).
Before TCP production gets underway, the project team should have a clear understanding of:
- Where work enters and exits public right-of-way
- Which municipality or county controls each segment
- Whether the route encounters CDOT-controlled roadways
- Where construction methods change
- Which sections affect travel lanes, shoulders, sidewalks, bike facilities, or intersections
- Where major equipment such as drill rigs, vac trucks, trailers, or reel trucks will actually be positioned
That last point is especially important.
A set of OSP construction drawings may show where conduit and fiber are going, but a Traffic Control Plan needs to account for how the contractor will actually build it.
Directional boring, potholing, trenching, handhole placement, fiber pulling, and splicing can create very different impacts on the public right-of-way.
One Fiber Project May Require Many TCPs
On a large telecom build, thinking in terms of a single “traffic control plan” can be misleading.
The project may require a series of TCPs corresponding to different work locations, construction phases, and jurisdictions.
Consider a hypothetical Front Range fiber route.
The first segment follows a residential street where crews can work primarily from the shoulder. Farther down the route, the bore crosses a busy arterial and requires a lane closure. The next section enters another municipality and impacts a sidewalk. Eventually, the alignment reaches a state highway where CDOT requirements come into play.
It’s one fiber project.
But from a traffic-control perspective, those are several distinct situations.
Organizing TCPs around those situations makes it easier for permitting teams to submit the appropriate plans and for construction teams to understand which approved setup applies when they reach each portion of the route.
Construction Method Matters
Telecom projects also differ from many traditional road projects because crews frequently move along the alignment.

A paving contractor might occupy a relatively defined work zone. Fiber crews can have a much more dynamic footprint.
A directional drilling operation, for example, may require space for the drill rig, support equipment, vacuum excavation, conduit, and entry and exit pits. A potholing crew may occupy a location for a relatively short period before moving down the route. Fiber pulling may require access to multiple handholes or vaults.
The TCP needs to reflect those operational realities.
If the plan provides a work area that doesn’t accommodate the actual equipment, crews may arrive in the field and discover that the approved closure doesn’t match the way the work needs to happen.
For telecom contractors, getting the traffic-control designer involved early can help identify those conflicts before permit approval and mobilization.
Watch the Jurisdiction Transitions
The transition points deserve particular attention.
A project manager shouldn’t assume that approval on one side of a municipal boundary automatically carries over to the other side. Similarly, work on a state highway may introduce requirements that aren’t present on an adjacent local road.
This is where organized plan production becomes especially valuable.
For longer fiber builds, it helps to maintain a clear relationship between:
Construction segment → Controlling jurisdiction → TCP → ROW permit → Construction phase
That sounds simple, but on a large build with dozens—or potentially hundreds—of plan sheets, keeping those pieces aligned can save substantial time when revisions arrive or construction sequencing changes.
Don’t Forget Pedestrians and Bike Traffic
Front Range telecom construction isn’t limited to vehicle lanes.
Fiber routes frequently follow sidewalks, multi-use corridors, commercial areas, and streets with significant bicycle traffic. A handhole in the wrong location or a drill setup occupying a sidewalk can create an entirely different traffic-control requirement than crews expected from reviewing the roadway alone.
This is particularly important in denser parts of Denver and other Front Range municipalities where the available right-of-way is already constrained.
The traffic-control planning process should consider everyone moving through the work area—not just motorists.
Changes in Construction Can Mean Changes to the TCP
Telecom construction changes. A bore alignment gets modified after a utility conflict is discovered. A handhole location moves. The contractor switches from boring to trenching for one segment. A drill setup needs to occupy more roadway than anticipated.
Those changes can affect the approved traffic-control configuration.
This is another reason TCP development should remain connected to the project team throughout construction rather than being treated as a one-time drafting exercise.
When field conditions or construction methods change, the traffic-control team can determine whether the existing plan still fits the operation or whether a revision is appropriate before crews proceed.
A Better Workflow for Large Fiber Builds
For multi-jurisdiction telecom projects, a more effective workflow looks something like this:
- Review the complete fiber alignment. Identify roadway types, jurisdictional boundaries, and likely traffic impacts.
- Break the route into logical construction segments. Consider both jurisdiction and the construction method being used.
- Identify the permitting authority for each segment. Don’t wait until the TCPs are finished to determine who will review them.
- Coordinate with the construction team. Confirm where drill rigs, vac trucks, excavators, trailers, and other equipment will actually operate.
- Develop TCPs around real field conditions. The plan should support the work—not force the field crew to improvise around an unrealistic layout.
- Track plans by jurisdiction and phase. Maintain clear plan naming and revision control so crews receive the correct approved TCP.
- Plan for revisions. Telecom routes evolve. Build enough coordination into the process to address changes without losing track of the permitting schedule.
Colorado Experience Matters on Front Range Fiber Projects

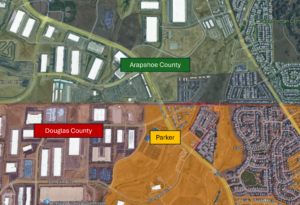

Multi-jurisdiction work isn’t unusual in Colorado.
The Front Range is a patchwork of municipalities, counties, major transportation corridors, and rapidly developing communities. A fiber route through the Denver metro area can encounter very different roadway conditions and permitting expectations within a relatively short distance.
Ikon Traffic Services develops Traffic Control Plans for fiber, telecom, utility, roadway, and other right-of-way construction projects, including projects involving municipal and state roadway requirements. We combine TCP design with real-world traffic-control experience so plans account for both the permitting process and what crews need once they reach the field.
For large OSP and fiber programs, we can also help organize TCP development across multiple construction segments and jurisdictions.
Planning a Multi-Jurisdiction Fiber Build?
If your fiber route crosses multiple Colorado jurisdictions, getting traffic control involved early can make permitting and construction coordination considerably easier.
